Water Main Project

Water Main Project

The Town of Richey is currently working on a water main replacement project to address leakage, breaks and replace aging water mains. The projects shown here are critical to achieving that goal. The information provided on this page will provide all relevant information regarding the improvements to the Town's water infrastructure.

Key Improvements Areas To Be Addressed:

  • High Water Loss
  • Above Average Leak Repairs
  • Inadequate Hydrants and Valves
  • Low Fire Flows
  • Inadequate Curb Stops
  • Low Storage

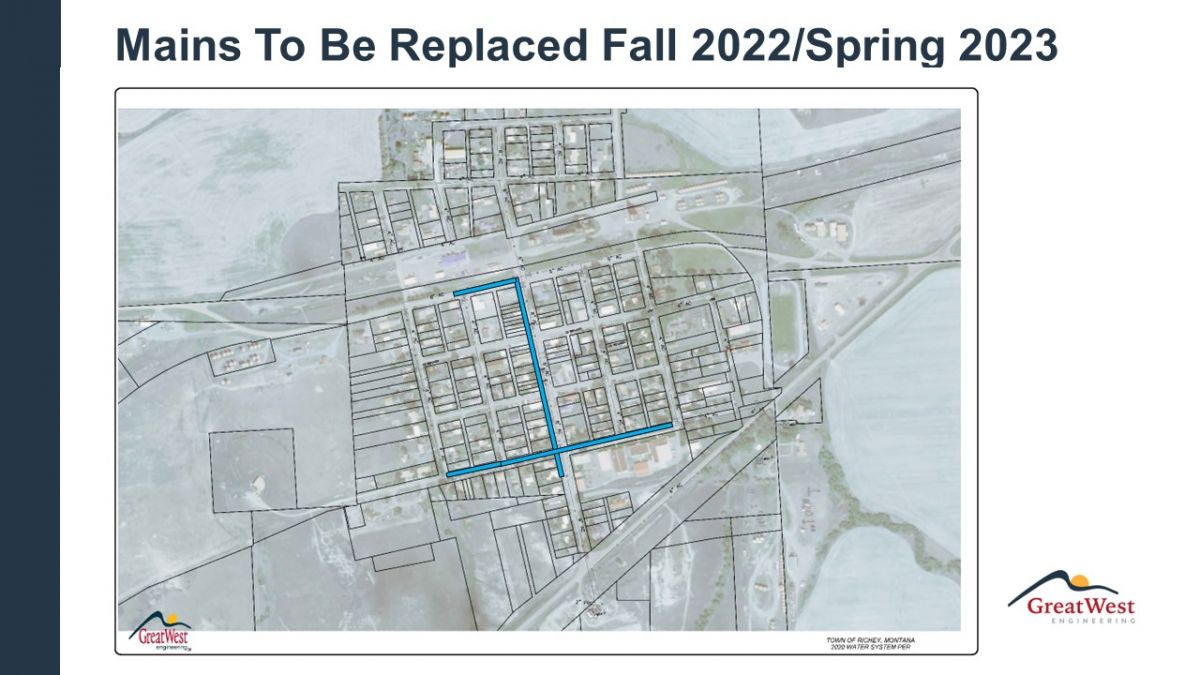

Phase 01:  Projected Progress


Phase 01 (Projected Progress)



  • Phase 01 Construction ETA:   April 2023
  • Phase 01 Project Status:         Awaiting Construction
  • Engineering Company:          GreatWest Engineering
  • Construction Company:         COP Construction

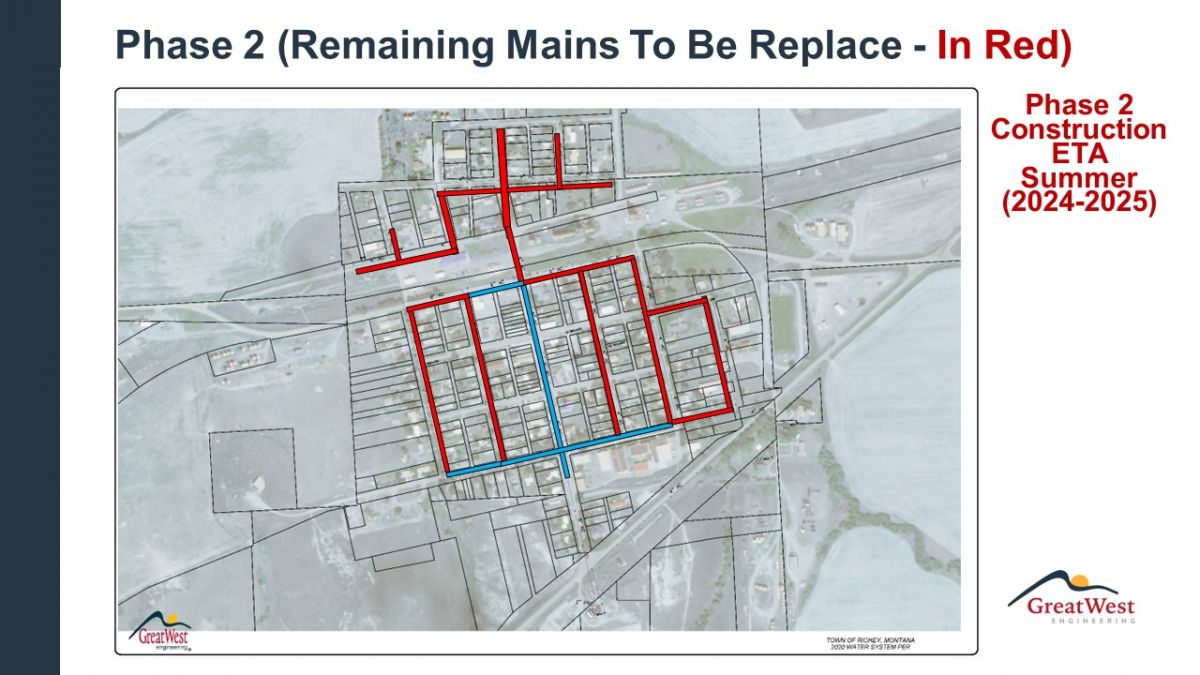

Phase 02: Projected Progress


Phase 02 (Projected Progress)



  • Phase 02 Construction ETA:   Summer 2024-2025
  • Phase 02 Project Status:         Awaiting Funding
  • Engineering Company:          GreatWest Engineering
  • Construction Company:         TBD

Phase 2 Funding Plan (Phased Approach)

TSEP Grant $ 500,000
DNRC Grant $ 125,000
CDBG Grant $ 600,000
SRF Loan $ 312,500
SRF Forgiveness $ 312,500
Total: $ 1,850,000

  * Project will be up to 83% Grant Funded

Funding Plan (Target Rates)

Current Water / Sewer Rate $ 99.86 / Month
Current MHI $ 60,000
Combined Target Rate $ 115.00 / Month
Operating costs Require $ 125.00 / Month

  * Rate Increase of $26.00 per month needed to meet operating cost.

To Obtain Grants, the Town of Richey Must meet or exceed the Target Rate.

CDBG Eligibility (Per 2022 Income Survey)

  • Richey Median Household Income = $60,000
  • Richey Low-to-Moderate Income = 64%

Phase 02:  Potential Schedule

Schedule is dependent on funding strategy:

  • MCEP Funds available in July, 2023.
  • DNRC / RRGL Funds available in July, 2023.
  • SRF Funds available in 2023.
  • Engineering Design = 3 Months
  • DEQ/RD Review = 3 Months
  • Bidding = 1 Month
  • Construction = Up to 4 Months.  Done in Summer, 2024-2025.
